Azure DevOps Services | Azure DevOps Server 2022 - Azure DevOps Server 2019
Velocity metrics provide valuable insights that help teams plan and forecast sprints, and evaluate how accurately they estimate and meet planned commitments. These metrics indicate how much work a team can complete during a sprint, based on either the count of work items completed or the sum of estimates for effort (product backlog items), story points (user stories), or size (requirements). Use velocity to aid in determining team capacity, but don't confuse it with key performance indicators.
Category | Requirements |
---|---|
Access levels | - Project member. - At least Basic access. |
Permissions | - Team administrator or project administrator or specific dashboard permissions granted to you. - To add a widget to a team dashboard: Member of the team. |
Feature enablement | Azure Boards enabled. If disabled, none of the work-tracking Analytics widgets are displayed. To re-enable it, see Turn a service on or off. |
Task awareness | Awareness of the required and recommended tasks, listed later in this article. |
Category | Requirements |
---|---|
Access levels | - Project member. - At least Basic access. |
Permissions | - Team administrator or project administrator or specific dashboard permissions granted to you. - To add a widget to a team dashboard: Member of the team. |
Feature enablement | - Azure Boards enabled. If disabled, none of the work-tracking Analytics widgets are displayed. To re-enable it, see Turn a service on or off. - Analytics installed and enabled. Members of the Project Collection Administrators group can add extensions or enable the service. Organization owners are automatically members of this group. |
Tip
The images in this article might differ from what you see in your web portal. These differences can be due to updates to your web app, options enabled by you or your admin, and the process chosen when creating your project (Agile, Basic, Scrum, or CMMI). The Basic process is available starting from Azure DevOps Server 2019 Update 1.
You can choose between two Velocity charts: the in-context Velocity chart from the Backlogs page and the Velocity widget for dashboards. Both charts help you quickly understand the workflow state categories described in the following table.
Items in the Proposed or Resolved states are excluded from the Completed, Completed Late, and Incomplete calculations. For more information, see How workflow category states are used in Azure Boards. Your selections are personal and persist across sessions until changed.
Workflow state | Description |
---|---|
Planned | Work items assigned to a sprint before it starts. If reassigned after the sprint begins, they remain Planned in the original sprint and appear as Late or Incomplete in the new sprint. |
Completed | Work items assigned to the sprint and completed before the end of the sprint. |
Completed Late | Work items assigned to the sprint but completed after the sprint ends. |
Incomplete | Work items assigned to the sprint but not yet completed. |
Resolved | Bugs assigned to the sprint, indicating a solution was implemented but not yet verified. |
Later in this article, learn how to open the Velocity in-context report or configure the Velocity widget.
You can configure each chart in the following ways:
The widget offers more configuration options. For more information, see Configure and view Velocity charts.
Velocity reports are available for both product and portfolio backlogs. Each report includes interactive controls, allowing users to customize the view to their specific interests.
Sign in to your project (https://dev.azure.com/{Your_Organization/Your_Project}
).

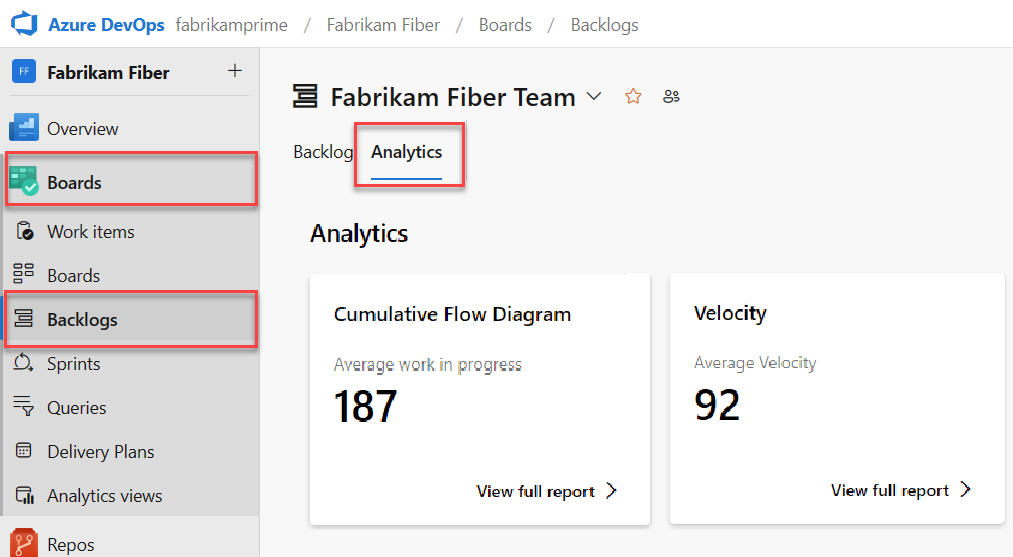

Select Boards > Backlogs > Analytics to open the Velocity report for your product or portfolio backlog.
To change to a different backlog, choose from the backlog selector, and then select View full report for Velocity.
Use the interactive controls to select the count or sum field and number of iterations. Select Custom iterations to specify any number of iterations between 1 and 15.
If your team doesn't complete a sprint or if you're working on items before a sprint start date, there's no data to analyze and forecast. The following message might display: Set iteration dates to use this widget. To resolve this situation, set an iteration date range to include present date or wait for the sprint to start.
Hover over a column area to show a summary of planned and completed work items. For example, for the 07_2019 sprint, 131 items are planned.
For more information, see the workflow state descriptions mentioned earlier in this article.

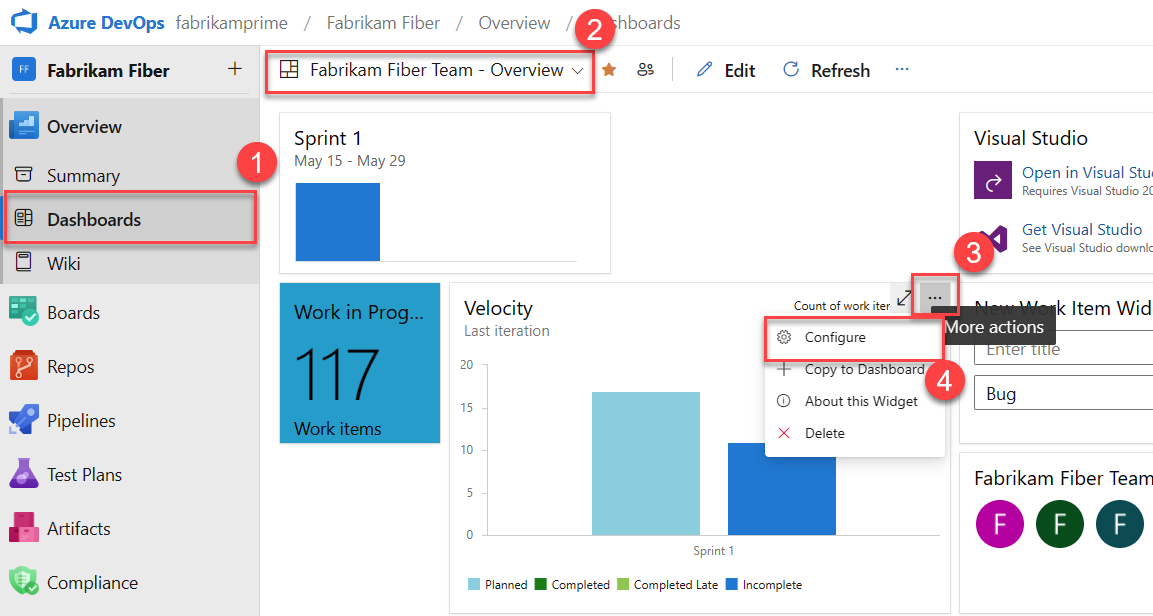

To add the report to a dashboard, select the
actions icon and select Copy to Dashboard.
Select the dashboard and select OK.
To return to the Analytics summary, select the
back arrow.
You can only configure your Velocity widget for a single team. If you want to view the velocity for several teams, then you must configure a portfolio management team that rolls up from several teams. For more information, see Add teams.
If you haven't yet, Add the Velocity widget to your dashboard. For Azure DevOps Server 2019, Enable or install Analytics.
Complete the following steps to configure the Velocity widget.

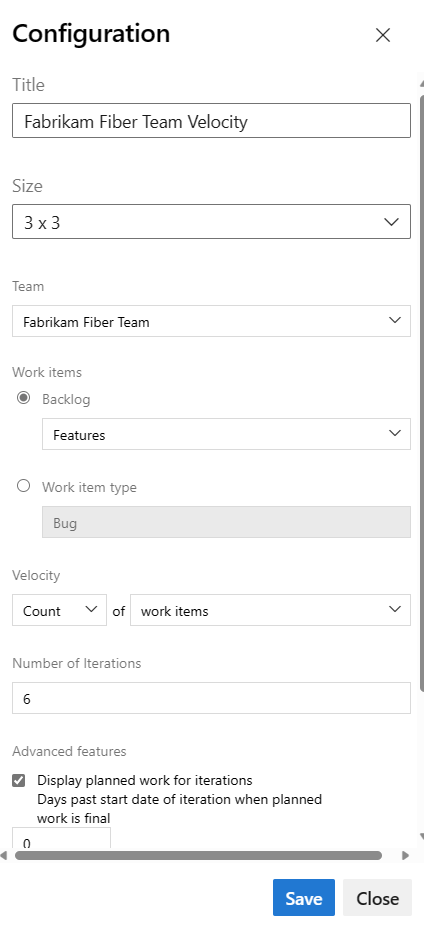

Select the actions icon and select the Configure option to open the configuration dialog.
Modify the title, select the team, and then select either the backlog level or work item type to track. Select whether you want to track a count of work items or a sum of a numeric field. The most common summed field is that of Effort, Story Points, or Size.
Specify the number of sprints you want to view. The default is 6 and the maximum is 15.
(Optional) Select the check boxes to show additional information for work completed later than planned for each sprint.
3
, and planned work gets counted on the third day. For example, if the iteration starts on 01/01/2024
, and three backlog items are assigned to the iteration on 01/01/2024

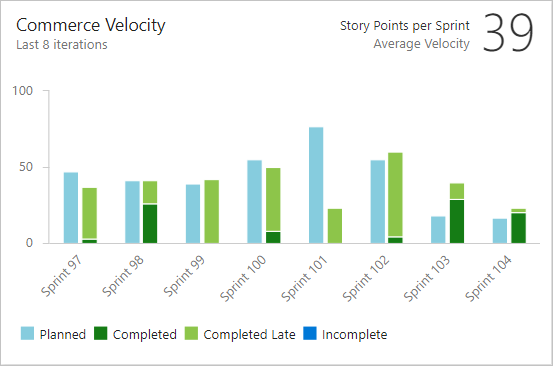

end-of-day, then those three backlog items are considered as Planned. If your team doesn't complete planning until a few days into the iteration, then you can update the Days past start date of iteration when planned work is final.Select Save. The following image shows Velocity based on Story Points and eight sprints of data.
For more information about Planned, Completed, Completed Late, and Incomplete states, see the State descriptions mentioned earlier in this article.
For your team to gain the greatest utility from the Velocity charts, follow these required and recommended tasks.
Important
If each team wants their own backlog view, Velocity chart, and forecast tool, you can add a new team. Each team has access to its own set of Agile tools, which filter work items to include only the assigned area paths and iteration paths specific to that team.
